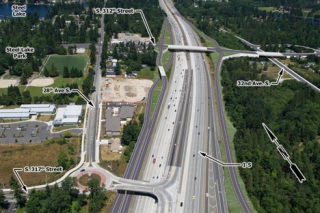

City Center Access in Federal Way: By the numbers

The City Center Access project has long been in the works. Here’s a look at the numbers and costs associated with the project.

• 2003: Year the project began

• $525,000: Spent on a feasibility study

• 8: Phases included in the project

• 2: Phase the project is currently in, which includes an environmental assessment

• $3.2 million: Spent so far on phase two

• 47: Traffic solutions initially introduced

• 3: currently considered solutions, including two build and one no-build option, presented in 2005

• 1: Final solution, likely to be Alternative One: South 312th Street, will be chosen

• 16: Residents, business owners and representatives comprise the stakeholder team, which helped narrow the solutions

• 28,000: Motorists currently traveling through the downtown area to Interstate 5 daily

• 2035: The year used to project future traffic estimates in downtown Federal Way

• 4 to 8: Number of homes and properties the city will need to acquire if it chooses to proceed with Alternative One

• $3.5 million to $4 million: Amount the city expects to spend to acquire those properties

• 2010: Expected year of completion for an environmental assessment and year in which property buyouts may begin

• 52: Steel Lake Park’s approximate number of acreage

• 5: Lanes South 312th Street will grow to between 24th Avenue South and 28th Avenue South, if Alternative One is approved by the city council

• 2: Lanes currently dividing the park’s north and south sides

• 2020: Estimated year of completion

• $160 million to $220 million: expected construction costs

• 15 to 20: Number of years to complete the project, depending on when funding is acquired

Source: City of Federal Way

All information provided by project manager Maryanne Zukowski, traffic engineer Rick Perez, city spokeswoman Linda Farmer and the city’s City Center Access Web page. Some information was taken from previous Mirror articles about the City Center Access project.
